Why Does a Sunroom Take Time Before Construction Starts?
A sunroom is a custom-built addition to your home. It is not something that can usually be pulled from inventory and installed immediately.
Before construction starts, your project may need to go through:
- CAD drawings
- Final design confirmation
- City, township, or municipal approvals
- HOA approval, when applicable
- Material ordering
- Factory production
- Installation scheduling
Building permit requirements vary by location. For example, Pennsylvania’s Uniform Construction Code requires property owners or authorized representatives to obtain building permits before beginning covered construction work, and local municipalities may have their own processes and enforcement procedures.
The International Residential Code also includes specific provisions related to sunrooms, which is one reason proper design, documentation, and approval steps matter before construction begins.

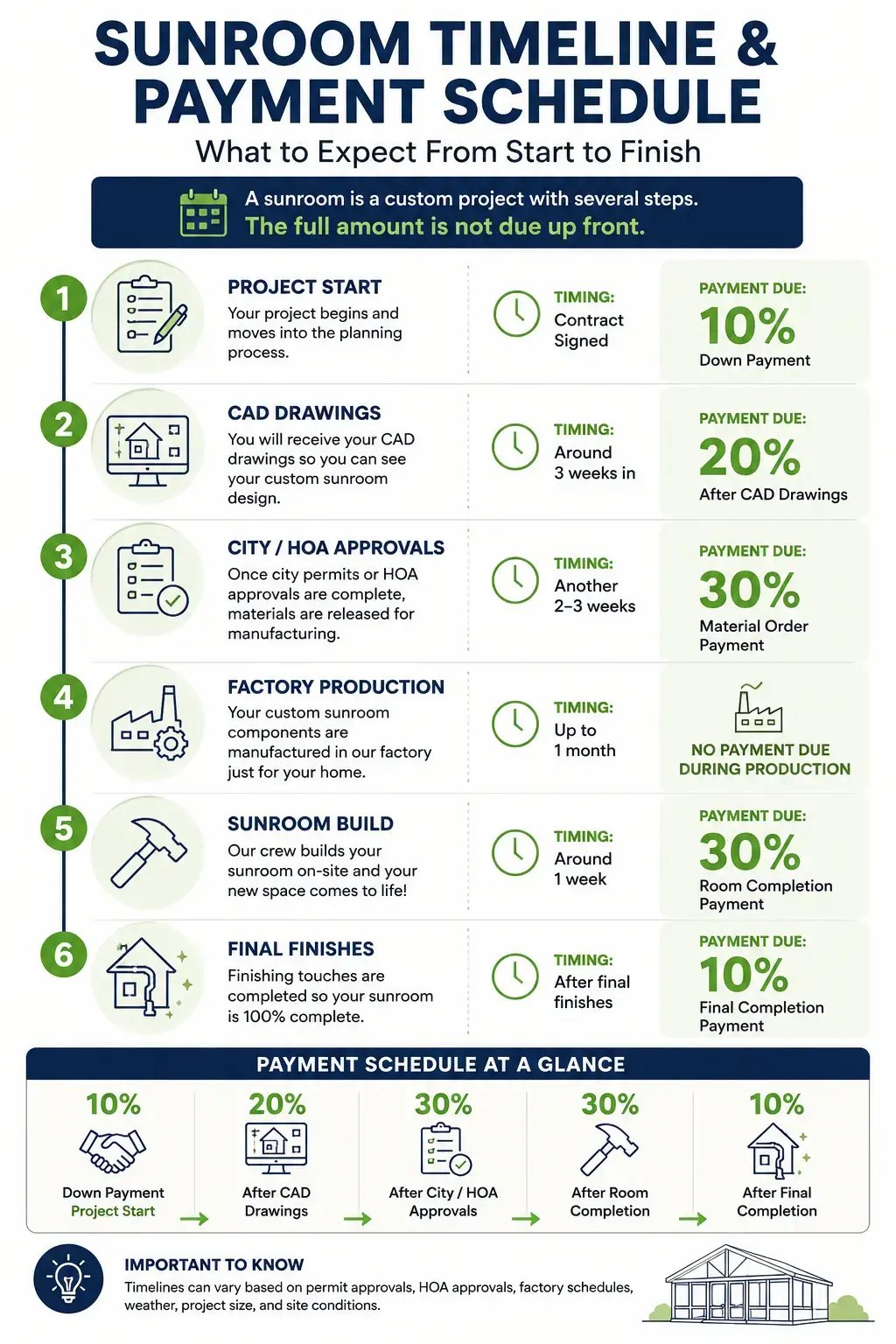

What Is the Sunroom Payment Schedule?
Here is how the Joyce sunroom payment schedule typically works.

Step 1: What Is Due When the Sunroom Project Starts?
The first payment is a 10% down payment.
This initial deposit gets the project started and moves the sunroom from estimate or consultation into the planning process.
At this stage, Joyce begins preparing the project for design, documentation, and the next steps needed before production.
Payment due: 10%
Milestone: Project start
Step 2: What Happens When CAD Drawings Are Completed?
Around three weeks into the process, the homeowner receives CAD drawings.
CAD drawings are detailed design documents that help show how the sunroom will be laid out and built. They give both the homeowner and the Joyce team a clearer view of the project before it moves further into approvals and production.
Once the CAD drawings are completed and provided, a 20% payment is due.
Payment due: 20%
Approximate timing: Around 3 weeks in
Milestone: CAD drawings completed and delivered
Step 3: When Are Materials Ordered for the Sunroom?
After CAD drawings are complete, the project typically moves into City, township, municipal, or HOA approval.
Depending on the home and location, this stage may include:
- Building permit approval
- HOA approval
- Project documentation review
- Local code requirements
- Final design approval before production
This phase often takes another two to three weeks, but the exact timeline depends on the local approval process and whether an HOA is involved.
Once the City or HOA approvals are completed, Joyce can release the project for material ordering and factory production. At that point, a 30% material order payment is due.
Payment due: 30%
Approximate timing: Another 2–3 weeks after CAD drawings
Milestone: City / HOA approvals completed and materials released for production
Step 4: How Long Does Factory Production Take?
Once approvals are complete and materials are released, your sunroom moves into factory production.
Factory production can take up to about one month.
During this stage, your custom sunroom components are made based on the approved drawings, measurements, and project details.
This is an important distinction: Joyce is a factory-direct home improvement company, meaning it designs, manufactures, and installs its own products rather than relying on a middleman for the full process. Joyce describes its sunrooms as custom-designed and factory-direct, serving homeowners across Ohio, Pennsylvania, North Carolina, and South Carolina.
Payment due: No separate payment listed for this stage
Approximate timing: Up to about 1 month
Milestone: Sunroom components are manufactured
Step 5: How Long Does the Actual Sunroom Build Take?
Once the materials are out of the factory and the project is scheduled, construction can begin.
The main sunroom build typically takes around one week, depending on the size, scope, site conditions, weather, and complexity of the project.
After the room build is complete, a 30% room completion payment is collected.
Payment due: 30%
Approximate timing: Build usually takes around 1 week
Milestone: Main sunroom structure completed
Step 6: What Happens After the Main Room Is Built?
After the main sunroom structure is completed, there may still be miscellaneous finishing work to complete.
These final items may include:
- Gutters
- Downspouts
- Electrical work
- Exterior finish details
- Final adjustments
- Cleanup
- Completion items
Once the total project is complete, the final 10% payment is collected.
Payment due: Final 10%
Approximate timing: After final finishing details are completed
Milestone: Total project completion

Why Is the Payment Schedule Set Up This Way?
The payment schedule is designed around how a custom sunroom project actually works.
A sunroom involves costs and stages of work that occur before, during, and after construction. Design work, approvals, material ordering, manufacturing, installation, and final finishing do not all occur simultaneously.
By spreading the payments across milestones, homeowners can better understand what each payment is connected to.
In practical terms, the payment schedule follows the project’s progress:
- Start the project
- Create the CAD drawings
- Secure approvals
- Order and manufacture materials
- Build the room
- Complete final finishes
This gives homeowners a clearer view of where they are in the project and what still needs to happen.
What Can Affect the Sunroom Timeline?
Even with a clear process, sunroom timelines can vary.
Common factors include:
- City, township, or municipal approval time
- HOA approval time
- Project size
- Three-season vs. four-season room design
- Site conditions
- Weather
- Electrical requirements
- Gutter and downspout work
- Factory production volume
- Final finish details
For example, a straightforward patio enclosure may be built differently from a larger four-season sunroom with more complex electrical, structural, or finish requirements. Joyce offers several types of sunroom and enclosure products, including three-season rooms, four-season rooms, patio enclosures, screen rooms, and patio covers. The project type can affect the planning and production process.

A Realistic Example of How This Could Look
Here is a simplified example of how a sunroom payment and timeline could unfold:
|
Approximate Stage |
Example Milestone |
Payment |
|
Week 0 |
Homeowner signs agreement |
10% |
|
Around Week 3 |
CAD drawings are completed and shared |
20% |
|
Around Weeks 5–6 |
City / HOA approvals are completed |
30% |
|
Following the production period |
Sunroom components are made in the factory |
— |
|
Build week |
Main sunroom structure is completed |
30% |
|
Final completion |
Gutters, downspouts, electrical, and details are finished |
10% |
This is not a guaranteed timeline for every project, but it shows how the payment milestones line up with the major stages of a Joyce sunroom project.
What Should Homeowners Ask Before Starting a Sunroom Project?
Before moving forward, homeowners should ask questions that clarify both timing and payments.
Good questions include:
How far out is the current sunroom schedule?
This helps you understand when your project may realistically move into construction.
When will I receive my CAD drawings?
This helps clarify when the design milestone happens.
Will my project need City, township, municipal, or HOA approval?
Approval requirements can affect the timeline.
When are my materials ordered?
This explains when the project moves into factory production.
When is each payment due?
This helps you plan financially and avoid surprises.
What happens after the main room is built?
This clarifies finishing details like gutters, downspouts, electrical work, and final completion items.

FAQ: Sunroom Timeline and Payment Schedule
Do I have to pay for the entire sunroom up front?
No. The full sunroom cost is not due up front. Payments are spread across the project and tied to milestones.
What is the first payment for a Joyce sunroom?
The first payment is typically a 10% down payment when the project begins.
When is the second payment due?
The second payment is typically 20%, due around three weeks after the homeowner receives CAD drawings.
Why is there a 30% material order payment?
The 30% material order payment is due after City or HOA approvals are completed and the project is released for factory production.
How long does factory production take?
Factory production can take up to about one month, depending on the project and current production schedule.
How long does the sunroom build take?
The main build typically takes around one week, depending on project size, weather, site conditions, and complexity.
What is included in the final 10% payment?
The final 10% is collected upon completion of the project, including miscellaneous finishing items such as gutters, downspouts, electrical work, and final detail work.
Can HOA approvals delay a sunroom project?
Yes. If your neighborhood has an HOA, approval may be required before production or construction can move forward. HOA rules and review timelines vary by community.
Can permit approvals delay the project?
Yes. Permit requirements and approval timelines vary by city, township, municipality, and state. That is why approval time is built into the overall sunroom process.

What Financing Options Are Available for a Sunroom Project?
For homeowners who do not want to pay for the entire project out of pocket, Joyce Factory Direct offers both short-term and long-term financing options.
Long-term financing is often helpful for homeowners who want to move forward with their sunroom project while keeping the monthly payment within a budget that feels comfortable. This can be a good fit for payment-focused buyers who are ready to start the project but prefer to spread the cost out over time.
Short-term financing may be a better fit for homeowners who are considering a home equity loan, waiting on funds, or simply want to use the bank’s money temporarily while keeping more cash available in savings.
One of the biggest benefits of financing is that it can reduce the upfront deposit. With financing, homeowners typically do not make additional payments during the project. Instead, the first bill usually arrives in the mail a few weeks after the sunroom is fully completed. That means you may be able to enjoy your new room before you even begin repaying the loan.
Financing can also be helpful for homeowners who want to stay more liquid. For example, you may already have money saved for part of the project, but not the full amount. Or you may have enough in savings but prefer not to drain it all at once.
Final Thought: A Clear Payment Schedule Makes the Sunroom Process Easier to Plan
A sunroom is a major investment, and homeowners deserve to know when payments are due and what each payment covers.
With Joyce, sunroom payments are milestone-based. The full balance is not due up front. Instead, payments are spread across the project as it moves through design, approvals, material production, construction, and final completion.
That transparency helps homeowners plan more confidently and better understand what happens between signing the agreement and enjoying the finished sunroom.
